Rain-Season Repair Approval Checklist
Anthony A. Luna • August 20, 2026
Rain readiness resources / Owner choices and repair requests
Southern California · Commercial and multifamily owners
Before approving a rain-season repair, make the condition, scope, cost, consequence of waiting, authority, and verification plan visible. Then record whether to approve, defer, or request more information, who owns the next step, and what evidence closes the work.
Editorial review: October 26, 2026. Use current local forecasts and property records for the next operating decision.
On this page
Use this page before deciding on a repair. Once the work is approved, the repair follow-through guide tracks vendor acceptance, scheduling and verification against that decision.
Ask for dated evidence, a decision deadline, and a field check. Confirm the authority provided by the property management agreement and the facts at the property before treating a request as approved.
Related guides for this decision
| Who acts | Decision or handoff | Verification | Next step |
|---|---|---|---|
| Property manager | Frame the condition, consequence and decision needed | Dated observation, location, photos, scope and cost basis | Set the owner decision date and field follow-up |
| Owner | Approve, defer or request more information within actual authority | Written decision tied to the property and request | Confirm the responsible person and next check |
| Vendor or specialist | Clarify technical scope and safe completion | Proposal, service record, photos or specialist finding | Report variance before changing the scope |
| Manager and field team | Verify the approved work reached the intended condition | Dated completion evidence and closure note | Keep deferred or incomplete work visible |
Which rain-season findings need an owner decision?
Major roof, drainage, pump, waterproofing, tree, erosion, electrical, or building-envelope work may need owner approval. The same can be true for specialist review, temporary controls, access changes, or work outside ordinary upkeep authority.
Start with the seasonal site readiness record. It should show prior incidents, current inspection findings, higher-risk areas, and work that remains open. The approval packet then focuses on the condition that needs an owner response.
Commercial properties may add tenant operations, loading, critical systems, and lease-specific facts. The commercial storm preparation guide explains how to include those continuity facts without assuming the same duty applies to every property.
What is the Condition to Closure decision sequence?

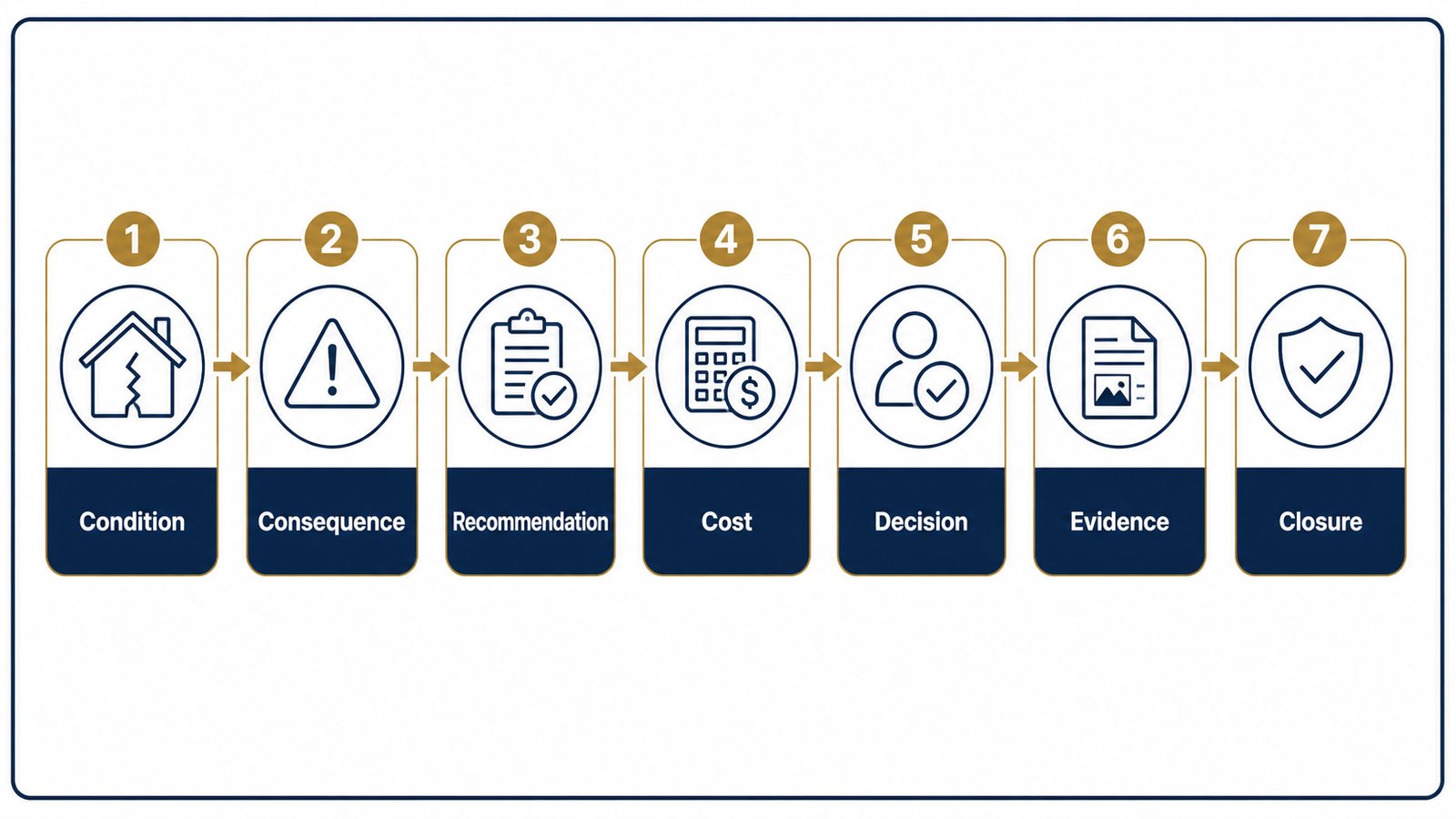

Before requesting approval, explain what was found and why the proposed work is needed. Coastline’s Condition to Closure framework organizes the record into seven parts:
- Condition. What was observed, where, when, and by whom?
- Consequence. What could the condition affect if it remains open, based on the property facts?
- Recommendation. What action or qualified review is proposed, and why?
- Cost. What bid or supportable estimate is available, and what is excluded?
- Decision. Who has authority, what response was recorded, and by what date?
- Evidence. What inspection, bid, field update, work record, or completion evidence supports the status?
- Closure. What checked result closes the condition, and what monitoring remains?
Identify what is holding the repair up. The team may still need a bid, the owner may have deferred the work, or the request may be unanswered. Record the actual status and assign the next follow-up. After the repair, check the result before closing the work order.
Condition
Name the property, building area, system, observed fact, date, and current status. Use approved photographs and prior records to show what was known when the packet was created. Avoid diagnosing a technical cause outside the observer’s qualifications.
Consequence
Connect the fact to a property-specific exposure such as water entry, access, equipment, occupied space, tenant operations, resident impact, or further damage. State the risk clearly and avoid unsupported financial outcomes.
Recommendation and cost
Describe the proposed scope, responsible discipline, dependencies, target timing, and likely consequence of delay. Attach the vendor bid or a supportable estimate when one exists. Identify exclusions and any investigation needed before the scope is final.
Decision, evidence, and closure
Record the approved choice, date, conditions, and next action. Preserve completion evidence, then check the result against each approved scope item. Before closing the item, record any monitoring trigger, responsible person, and next review date.
How can owners request additional bids without losing the decision window?
Additional bids can improve cost comparison and clarify scope. They can also consume a limited pre-storm work window. Give the owner the tradeoff instead of treating a bid count as the answer.
Show the urgency of the work and whether the vendor has capacity. Explain the known condition, proposed scope, the vendor’s knowledge of the property, access needs, and likely consequence of delay. If the owner requests another bid, name the person who will obtain it and set a due date. Record the next step if the bid is missing when the decision is due.
Do not manufacture urgency. A routine planned item and an active electrical hazard need different treatment. The observed condition and qualified input should determine the pace.
How should emergency authority stay property-specific?
Urgent authority depends on the property management agreement, the facts, and applicable law. The decision record should identify the controlling authority and the observed condition. Do not substitute a generic dollar threshold.
When fast action is supported, preserve the reason, person acting, scope, vendor acceptance, owner updates, and follow-up. When prior approval is required, keep the request and response window clear. Material legal or authority questions belong with the accountable owner or qualified legal review.
How should deferred or declined work be documented?
Deferring a repair does not establish that the condition is safe or that a legal duty has been satisfied. If an urgent safety concern or active damage develops, escalate it under the property’s actual urgent-response process. Reassess the condition and needed response instead of treating the earlier deferral as a final answer.
A deferral should preserve the inspection evidence, recommendation, bid, owner response, follow-up date, monitoring rule, and any later change in condition. Record the decision in the durable property file rather than leaving it in an isolated email thread.
State the interim control and remaining exposure. If a pump is being monitored, name the test plan and failure trigger. If a roof repair is deferred, identify the affected area, temporary measure, event check, and date the recommendation returns for a decision.
Reopen the packet when the condition changes. New intrusion, visible movement, a failed test, restricted access, or a shorter weather window can change the consequence and the decision deadline.
What belongs in a complete rain-season approval packet?
| Field | Minimum useful content |
|---|---|
| Location | Property, building area, system, and exact observed point. |
| Condition | Dated observation with photographs or a supporting record. |
| Consequence | Property-specific operating or safety exposure and material uncertainty. |
| Recommendation | Proposed action, qualified discipline, scope, dependencies, and timing. |
| Cost | Proposal or supportable estimate, exclusions, and bid status. |
| Decision | Decision owner, deadline, response, and any conditions. |
| Closure | Completion record, verification, residual monitoring, and next trigger. |
California Department of Water Resources guidance encourages preparation before flooding and following official direction. Sending a complete repair recommendation early gives owners time to consider the work before a storm limits access or planning.
How should an approval be followed through in the field?
An approval request should make the decision possible. Include the location, observed condition, proposed scope, cost or proposal reference, consequence of waiting, decision date, target completion, and evidence required for closure.
Record the condition, temporary control, monitoring owner, next review date, and change that would return the item for decision. A deferral does not establish safety or compliance.
Use California DWR’s flood-preparedness guidance for public planning context. Use the property record for the decision itself.
Follow the approval into the field and keep FIELD VERIFICATION PENDING visible until the check is complete.
What questions do owners ask about repair approvals?
Which storm-readiness repairs usually require an owner decision?
Major roof, drainage, pump, waterproofing, tree, erosion, or electrical work may require approval. Other non-routine work depends on the property management agreement, the facts, and the scope.
Should owners always get multiple bids before storm work?
Not necessarily. Additional bids can improve comparison, but the decision should also account for urgency, vendor capacity, scope clarity, known condition, and the consequence of delay.
What should a repair recommendation include?
Show the property, observed condition, evidence, recommended action, consequence of delay, vendor bid or supportable estimate, approval deadline, responsible party, and target completion date.
How should a declined or deferred recommendation be documented?
Preserve the inspection evidence, recommendation, bid, owner response, follow-up date, monitoring rule, and any later change in condition.
When can a property manager act without prior owner approval?
That depends on the property management agreement, the urgent authority provided, the facts, and applicable law. Confirm the authority that applies to the actual care arrangement before acting.
For management support with this work, review our commercial and multifamily property management services and Southern California service areas. Bring the condition or record you need help reviewing.
Get the information you need before approving repairs
If a repair request lacks a clear scope, cost, or explanation of urgency, bring a recent case to a Property Management Performance Review.
Request a Property Management Performance Review
Next steps for this decision
Sources
About the Author: Anthony A. Luna
Published · Last Updated
Anthony A. Luna is the Owner and CEO of Coastline Equity and author of Property Management Excellence. A licensed California real estate broker, he leads commercial and multifamily management operations across Southern California.
Services & Regional Coverage
Southern California Property Management
Coastline Equity delivers full-service property management for commercial centers and residential communities across Southern California. Connect with our team to discuss your property's operational needs.
Request a Property Consultation →


More about Coastline Equity
-
Explore Our ServicesOur team will handle all your property needs, offering specialized services such as in-depth inspections, liability management, staff recruitment and training, and round-the-clock maintenance—expert support tailored to the unique requirements of your real estate assets.
-
Our CompanyOur dedicated team transforms property management challenges into opportunities. From tenant management to streamlined rent collection and proactive maintenance.
-
About Our CEOAnthony A. Luna is CEO of Coastline Equity and author of Property Management Excellence. He writes about Southern California commercial and multifamily property management, owner decisions and the work required to follow repairs through completion.
-
Explore Our BlogLearn more about Coastline Equity's property management practices & processes and how we support our clients with education and a growth mindset. Coastline Equity Property Management is your partner as you continue to learn and grow.
News & Updates
